Project Overview
The roundabout improvements at the intersections of Rough and Ready Highway/Ridge Road and Ridge Road/Adams Ave have three primary goals.
- Reduce delays caused by stop-and-go traffic and the carbon emissions produced by vehicles idling and waiting.
- Improve safety by reducing accidents caused by improper turning and right-of-way violations.
- Enhances pedestrian safety by adding new multi-use pathways and crosswalks.

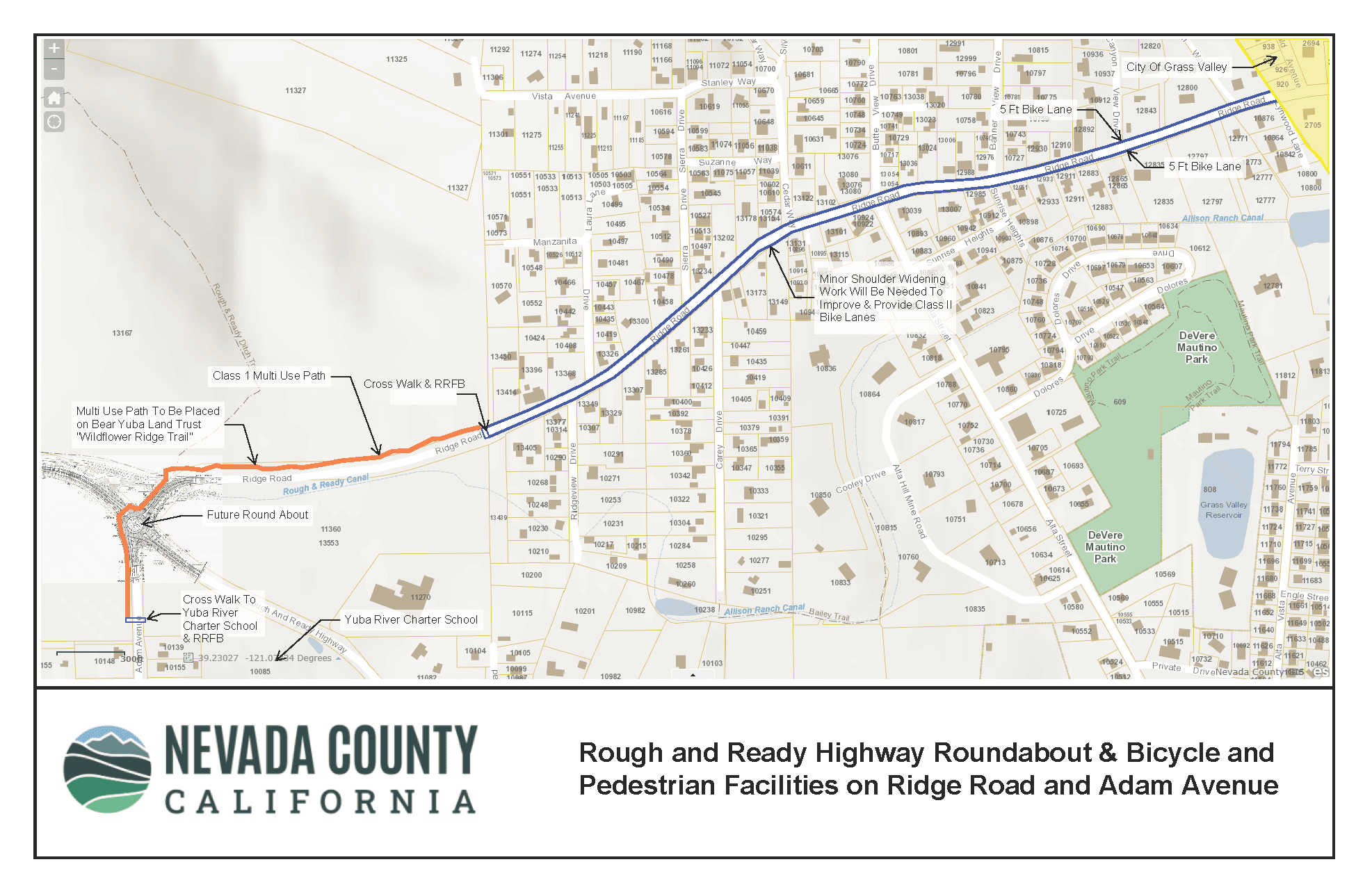

This project will add substantial pedestrian improvements, including approximately 1.1 miles of pedestrian/bike paths and designated bike lanes along Ridge Road, through the roundabout, and continuing approximately 700 feet along Adam Ave. Designated bike lanes will be directly adjacent to the roadway, and the pedestrian/bike paths will be separate from the roadway.
Schedule
| Steps | Description | Status |
|---|
1 | Grant Applications and Secure Funding | Ongoing |
2 | Design Phase | Current - Spring 2026 |
3 | Environmental Phase | Current - Fall 2025 |
4 | Right of Way Phase | Fall 2025 - Spring 2026 |
5 | Construction | Fall 2026 - Spring 2028 |
Current Status
The project is currently working though the design and environmental phases. Grant applications are being submitted for the construction phase.
Funding
Current Funding sources include Congestion Mitigation Air Quality Funds, General Fund MOE, State Exchange Funds, and Development Fee Funds.
Environmental Review
Project is working through the environmental phase and will be posted for public review tentatively in late Summer 2025.
Contact Information
Nevada County Department of Public Works - Engineering Division (530) 265-1411
